Construction progress January 19-23

Text and photos by Joe Lattuca, senior superintendent for ReArch Construction:

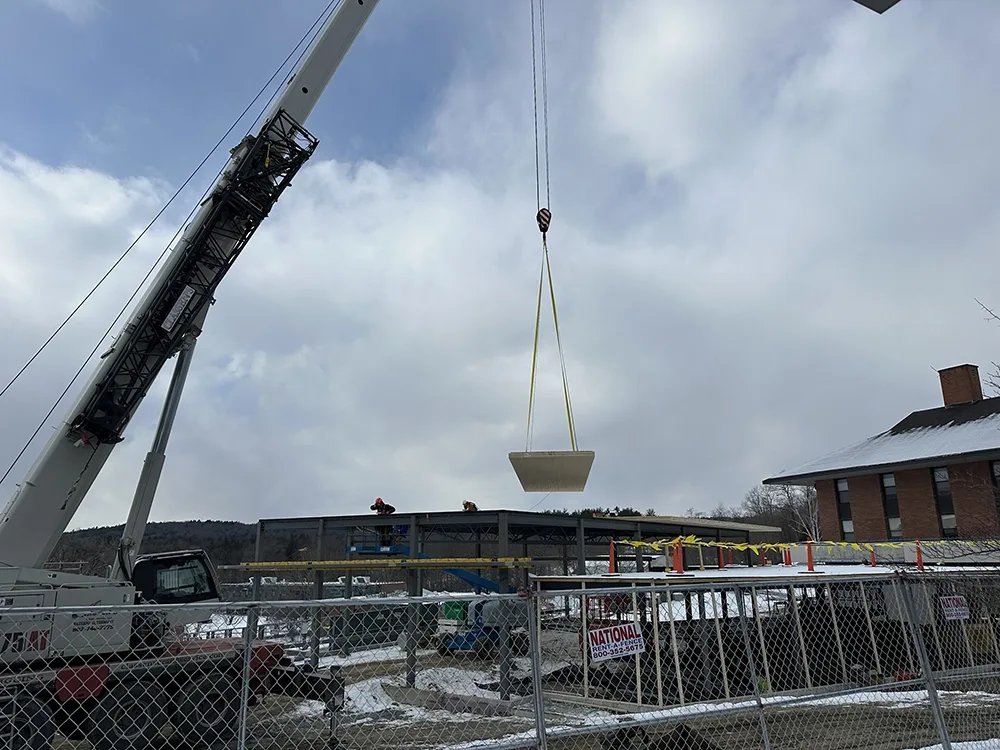

crane lowering a panel on to roof of structure
After temporary beams were replaced with the long span bar joist at the Great Room, we were right behind to install blocking on top of the steel.



view of construction site from underneath panel
On Friday, the cross-laminated timber (CLT) team got the panels set.

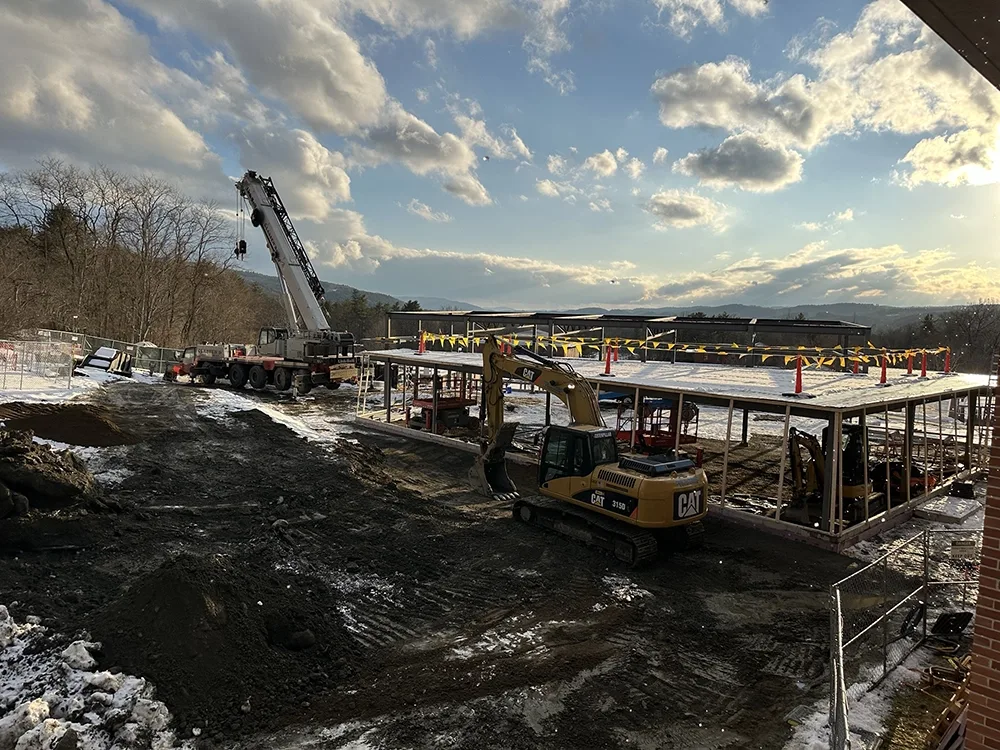

excavator digging through dirt at construction site
Meanwhile, we continued to utilize the ground thaw unit to thaw out areas to keep moving with the underground utility work.



sunset view of construction site
Next week, we will be wrapping the structure with poly and setting up temporary heat as the roofers gets started.
